SPECIAL BOARD MEETING

Thursday, May 14, 2026 · 9:00 a.m. · BCAG Board Room, 326 Huss Drive, Chico

Item 1

Call to Order & Pledge of Allegiance

Item 2

Public Comment

Members of the public may address the Board on any matter not already listed below. The Board cannot act at this meeting on requests made under this section of the agenda.

Item 3

Approval of Minutes — April 15, 2026

Review and Take Appropriate Action

Draft minutes are included in the printed packet (pp. 4–8).

Item 4

Finances & Payment of the Bills

Review and Take Appropriate Action

FY 2025–26 Budget vs. Billed YTD (Jul 2025 – Apr 2026)

$152,642 billed against a $619,400 approved budget — 24.6% utilized through April; $466,758 remaining.

May 2026 Itemized Bills

CategoryDescriptionAmount
PersonnelGiezentanner & Associates – General Manager$14,583.33
External SupportKlein DeNatale Goldner – General Counsel$977.50
Technical SupportProvost & Pritchard – Keefer Slough / Rock Creek Flood-MAR$4,794.82
Total$20,355.65

Office Supply & Printer Toner — Staff Memo

VendorItemAmount
StaplesHammermill copy paper, 2 cases (20 lb., 92-brightness)$87.38
AmazonHP 202X color toner set + 206X black toner$560.21
Total Request$647.59
Item 5

South Vina Extension — Phase 1 Consultant Selection

Review and Take Appropriate Action

Action Requested. Select the Water & Land Solutions / Provost & Pritchard joint proposal and authorize the General Manager to execute a not-to-exceed contract of $19,950.

Why Accelerate Now — Sequencing Through the Prop 4 Window

May 14, 2026
Board selects consultant (today)
Late May
Phase 1 kick-off
Jun–Jul 2026
Strategic scoping, cost re-engineering, 408 strategy
Aug 2026
Vina GSA consistency determination submitted
End of 2026
State finalizes Prop 4 guidelines
Early 2027
First Prop 4 application windows open ($386M available)

Proposal Comparison

Geosyntec Consultants, Inc.

Sole proposal · Amer A. Hussain, P.E. (Fresno)

Total fee$20,000 T&M, NTE
Proposal length3 pages (fee letter)
Team named1 member
ReferencesNone
Task-level budgetNot provided
Schedule detailFinal delivery July 30, 2026
Phase 2 SOWNot included
Rate sheetsReferenced, not attached
ContinuityEngineer of record on 2025 Feasibility Analysis
Section 408 experienceNot detailed in proposal
Phase 2 considerations remain open. Selecting WLS/P&P for the strategic Phase 1 engagement does not preclude Geosyntec, P&P, or EKI from competing for the Phase 2 engineering work.
Item 6

SWEEP Block Grant — Concept Proposal (Prop 4 Climate Bond)

Discuss and Take Appropriate Action — Resolution No. 2026-XX

Action Requested. Adopt Resolution authorizing the GM to submit a $4M regional SWEEP block grant concept proposal to CDFA, with TWD as lead applicant and fiduciary. Concept proposals due May 15, 2026.

Regional Partner Structure

Tuscan Water District Lead Applicant · Fiduciary · CDFA Liaison · Oversight & Reporting
Butte County Farm Bureau Subrecipient · Day-to-day program management, producer outreach, administrative support
AGUBC Technical Assistance Provider · Butte County (continuing current role)
Sutter County RCD Technical Assistance Provider · Yuba & Sutter Counties · Bilingual outreach

$4,000,000 Budget Allocation

77% to producers 23% admin · TA
~$3,080,000 to producers 77% Competitive on-farm grants across Butte, Yuba, and Sutter counties.
~$920,000 administration & TA 23% Divided among TWD, BCFB, AGUBC, and Sutter RCD under standard CDFA categories. Final figures set in full proposal.
Risk and commitment. Submitting a concept proposal does not commit the District to any expenditure or contractual obligation. Full proposal, grant agreement, and budget actions return to the Board for separate approval.
Item 7

FY 2026–27 Annual Assessment — Process & Timeline

Informational Update · Rate: $4.91/acre · Total Budget: $472,069

May 14
Informational update (today)
June 17
Board adopts certifying resolution
Mid-July
Reconcile parcel records against County edit list
By Aug 10
Submit complete packet (resolution, certifications, parcel listing) to Auditor-Controller per Gov't Code §26911
By Sep 1
Return signed final Certification of Property Tax Bill Levy
Rate authority. $4.91/acre is well below the $7.14/acre Year 2 maximum authorized by the Prop 218 Engineer's Report, and a meaningful reduction from the $6.45/acre FY 2025–26 rate — reflecting reserves carried forward and pressures on the agricultural economy.

What carries forward from Year 1 (no new action required)

Item 8

2026 General District Election — Preliminary Overview

Informational · Election Day: Tuesday, November 3, 2026 · Odd-numbered seats (1, 3, 5, 7, 9)

May 14
Preliminary overview (today)
June 17
Comprehensive calendar review & pre-July 1 actions
July 1
Notice of Offices to County Clerk
Jul–Aug
Publication & candidacy filing windows
Nov 3
Election Day
Dec 4
New directors take office at noon

Key Statutory Dates

DateActionAuthority
July 1, 2026Secretary delivers Notice of Offices to be FilledEC §§ 10509, 10524
July 6 – Aug. 5Publication window for Notice of ElectionEC §§ 12112, 10515
July 13 – Aug. 7Declaration of Candidacy filing; Candidate Statements dueEC §§ 10510, 13307
July 16Deadline to authorize vote-by-mail in lieu of vote-by-proxyEC § 10531
Aug. 5Last day to adopt ordinance updating assessment rollWat. Code §§ 35003, 35003.1
Aug. 12Extended filing if any incumbent does not fileEC § 10516
Nov. 3Election Day
Nov. 5Canvass commencesEC § 10547
Dec. 4New directors take office at noonEC § 10554; Wat. Code § 34701
Item 9

Vina GSA Periodic Evaluation — Update

Review and Take Appropriate Action · Seven subtopics

a GSP Plan Evaluation Process & Timeline

Fall 2025
Roadmap & stakeholder input on PE topics
May 2026
SHAC: Land Subsidence, ISW approach (now)
May–Aug 2026
SHAC & Joint GSA Board meetings on all PE topics
Aug 2026
PE available for public review & comment
Fall 2026
Review comments, finalize for adoption
Jan 2027
Submit PE to DWR
Overall focus. Address DWR's 6 Recommended Corrective Actions and provide a written assessment of GSP implementation. DWR's determination on submission: Approved, Incomplete, or Inadequate.

b Domestic Well Mitigation Program — SHAC Recommendations

Periodic Evaluation Recommendation

The SHAC recommends the PE describe that during the next implementation period, the GSA will develop a Well Mitigation Program that fits the needs of the subbasin.

Near-Term Action Recommendation

SHAC recommends the GSA Board dedicate funding in the FY 2026–27 Annual Budget to initiate program development in early 2027 after all SGM Grant Projects are complete, so as not to overload staff capacity.

SHAC consensus was unanimous despite differing perspectives on timing and approach. Attachments: LWA Tech Memo on Domestic Well Survey & Risk Assessment; Mitigation Programs Summary Matrix; Well Registry Programs.

Reported Dry Wells in the Vina Subbasin

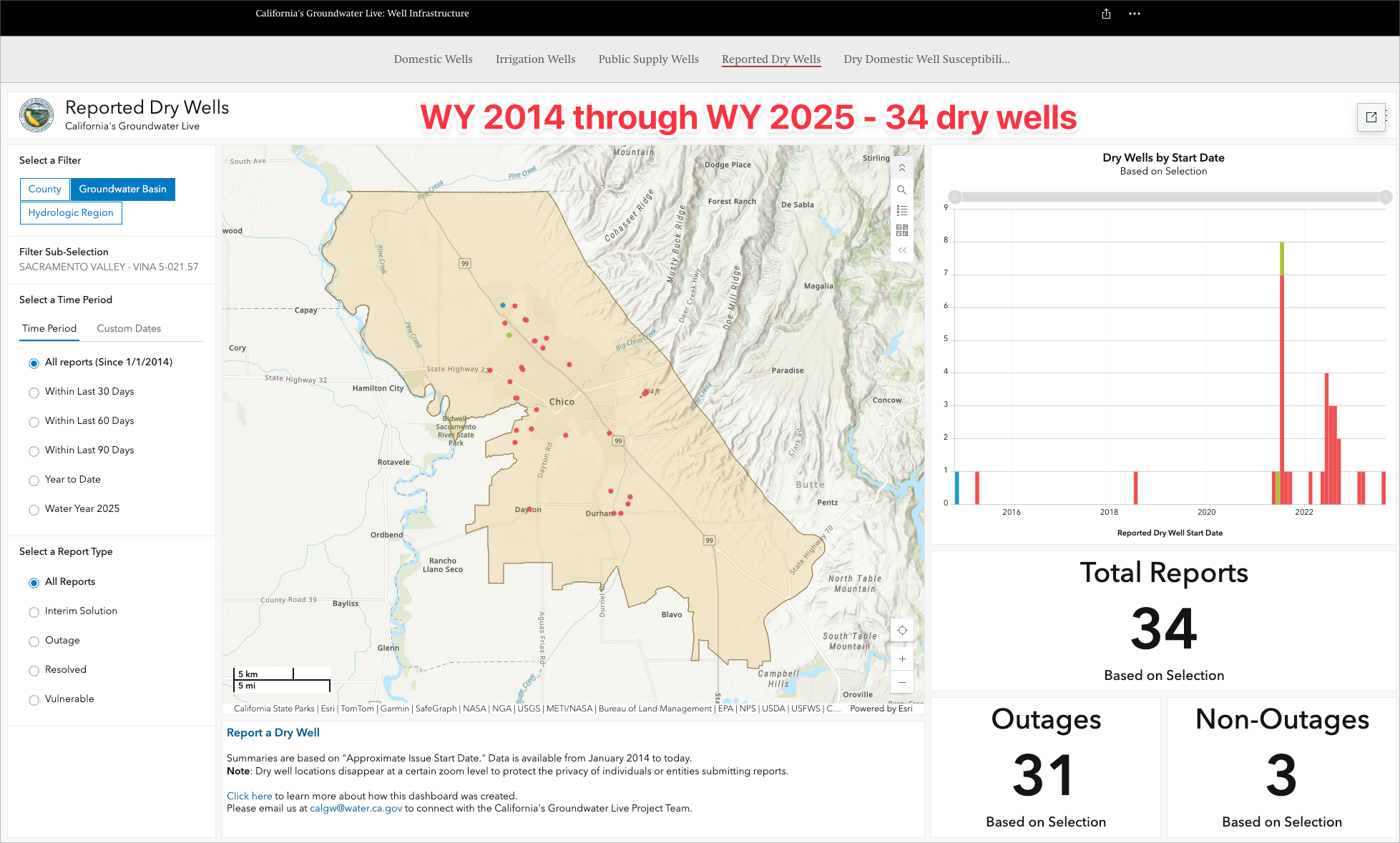

Reported dry wells in the Vina Subbasin, WY 2014 through WY 2025: 34 total
34 reported dry domestic wells in the Vina Subbasin, WY 2014 – WY 2025. California's Groundwater Live (Reported Dry Wells dashboard), all reports since Jan. 1, 2014 — covering the driest 22-year stretch in the last 1,200 years.

By Way of Contrast — Tehama County

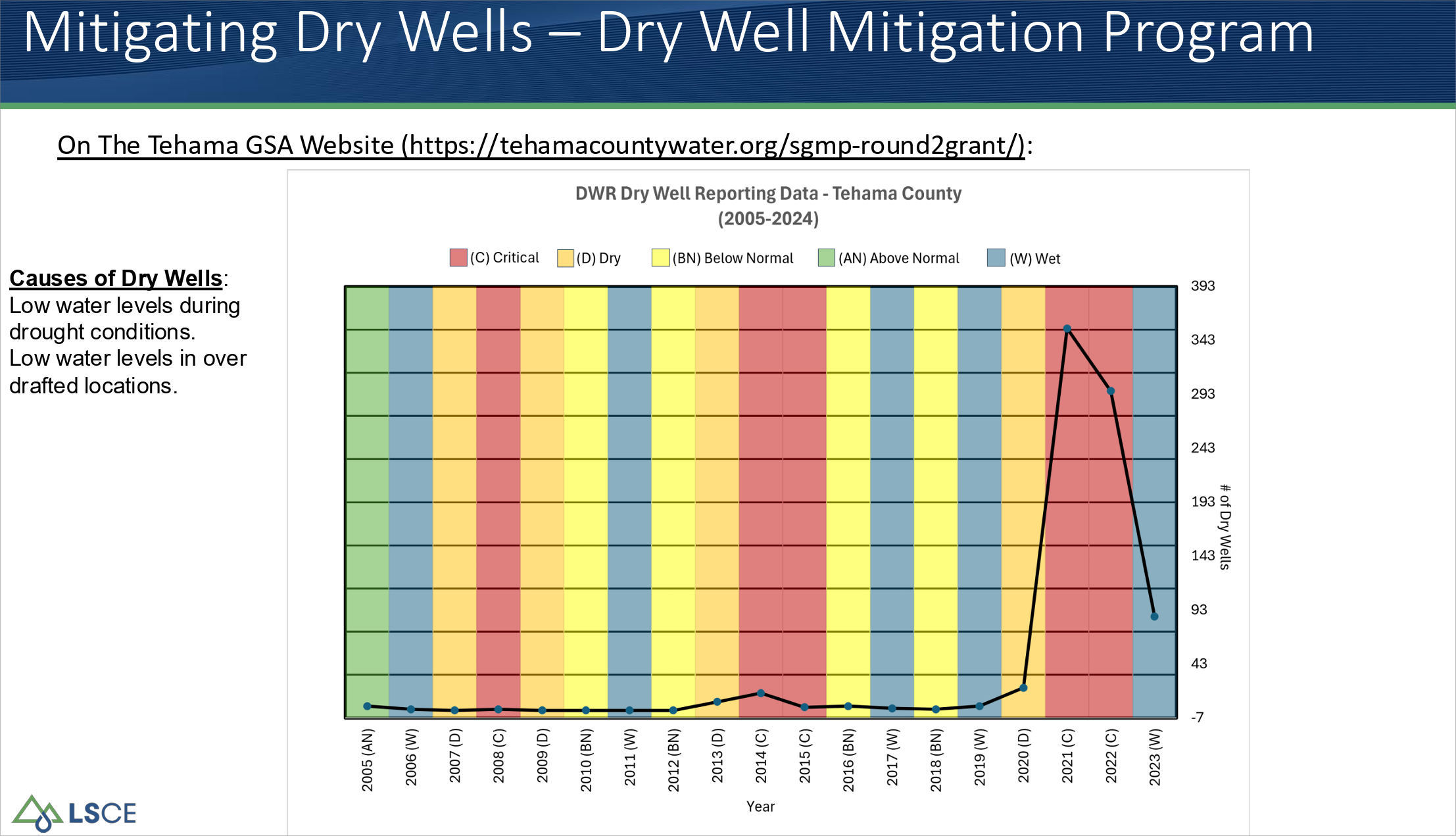

Tehama County reported dry wells by water year, 2005 through 2024
Tehama County · 2021–2023 · 729 reported dry wells. DWR Dry Well Reporting Data, Tehama GSA / LSCE.

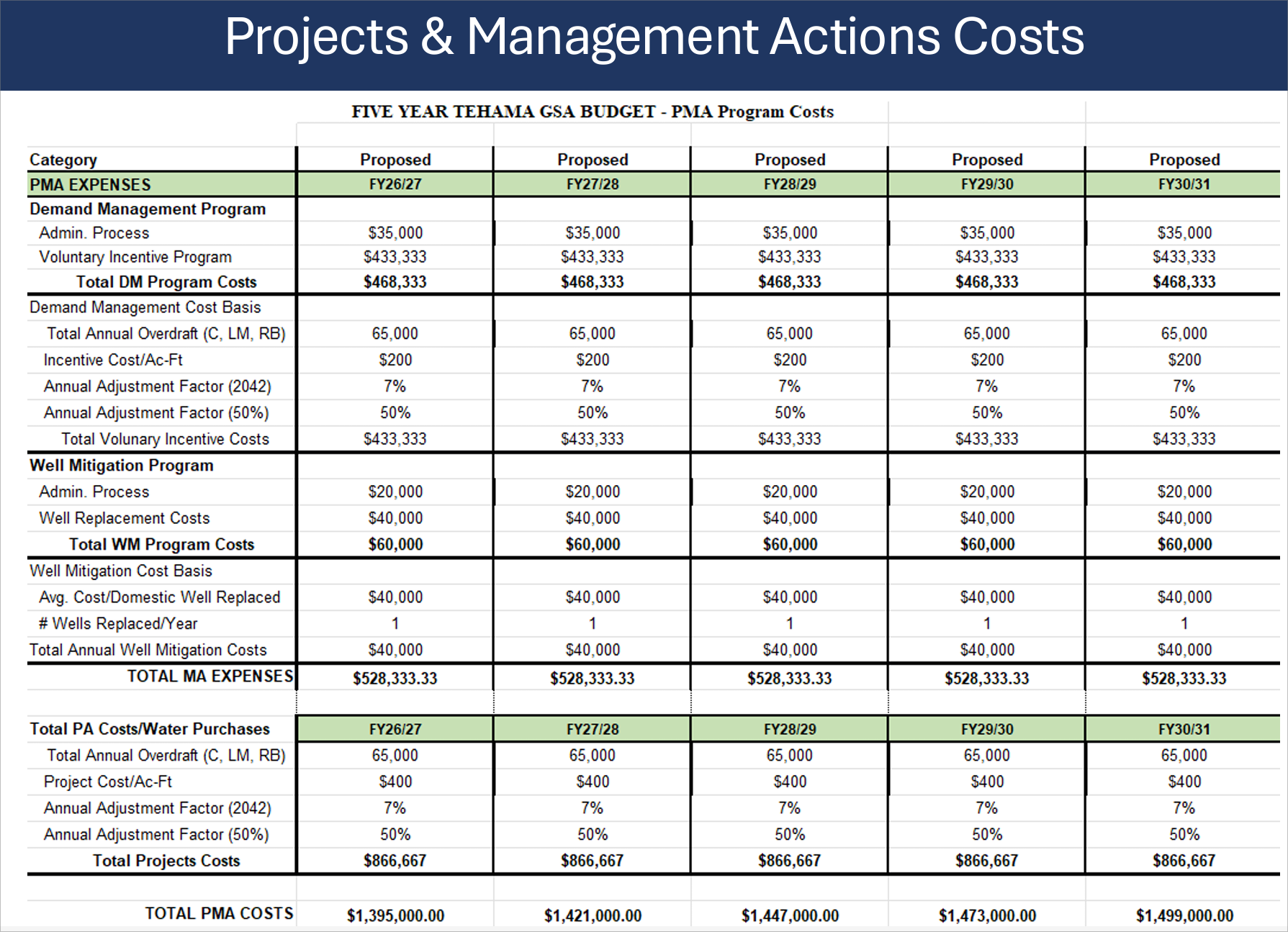

Tehama GSA Well Mitigation Program: 1 well replaced per year at $40,000
Tehama GSA Well Mitigation Program · 1 well replaced per year · $40,000/yr. Five-year proposed PMA budget (FY 26/27 – FY 30/31).
DWR Recommended Corrective Action 3. RCA 3 requires the Vina GSA to "Provide information on impacts to domestic wells during projected conditions where minimum thresholds are exceeded but undesirable results do not occur and also quantify domestic wells that will be impacted by the proposed minimum threshold. Furthermore, the GSAs should evaluate the impacts of proposed minimum thresholds on other beneficial uses and users, such as public and small water systems and environmental users and users."

What this condition does not say is, develop and implement a domestic well mitigation plan. Nevertheless, the Vina GSA has set aside funds to begin the process of creating a domestic well mitigation plan, which will begin in early 2027.

c Land Subsidence Strawman — Landowner Position

The Vina GSA's April 24, 2026 strawman proposal for land subsidence SMC, responding to DWR Recommended Corrective Action 5. The table below sets out the landowner position section by section.

Summary: 9 proposed edits · 4 provisions retained as written
# Section / Topic Strawman as Drafted Landowner Position Why
1 Minimum Threshold (MT) 0.2 ft/yr at any RMS, OR 0.5 ft / 5-yr cumulative (stacked triggers) EDIT — 0.5 ft / 5-yr cumulative only, attributable to declining groundwater levels. No DWR-approved Sac Valley basin uses a single-pixel annual-rate MT. Matches Red Bluff, Los Molinos, Corning, Butte, Wyandotte Creek draft.
2 Undesirable Result — Trigger 2 >0.1 ft/yr across 10 contiguous PLSS sections for 2 consecutive years (Colusa-style) EDIT — Removed. Colusa adopted for a basin with measured subsidence; Vina has none. Untethers UR from land-use-harm requirement of 23 CCR § 354.28(c)(5)(A).
3 Undesirable Result — Trigger 1 MT exceedance (annual-rate) + confirmed infrastructure impact, 2 yrs EDIT — MT exceedance (cumulative) + infrastructure impact + groundwater-level causation finding, 2 yrs. Updates MT reference to cumulative trigger; adds Red Bluff / Los Molinos causation gate ("as a result of declining GWL").
4 Relationship to Groundwater Conditions Groundwater-level framework abandoned entirely EDIT — GWL framework retained as leading indicator alongside InSAR; subsidence-driven PMAs conditional on observed subsidence. BMP § 6.8 endorses GWL framework in basins without observed subsidence; BMP § 7.4.2 sequences Scenario 2 PMAs after detection.
5 Interim Milestones "0.0 ft/yr maintained" (duplicate of MO) EDIT — No IM established (or 0.0 ft/yr). BMP § 6.5: "interim milestones is not necessary" in basins without observed subsidence and with MO at zero.
6 Measurement Uncertainty "Approximately 0.05 to 0.10 ft/yr" range EDIT — "< 0.10 ft/yr" (single value). Eliminates interpretive disputes near the boundary. Anchored to BMP § 6.3.
7 Sustainability Indicator Description Geologic-substrate finding omitted; conditional risk pathway only EDIT — Geologic-substrate finding restored; SVSim Sy ≈ 0.085 support; 4-yr (WY 2022–25) empirical record of no inelastic subsidence. DWR's 2023 Staff Report accepted "subsurface materials not susceptible to subsidence." Strongest empirical anchor for Scenario 2.
8 Monitoring Network — Spatial Criteria "Areas of groundwater extraction (west of Hwy 99)" leads EDIT — Critical infrastructure leads; mechanism-based criteria follow; Management Area coverage added. 23 CCR § 354.28(c)(5)(A) ties subsidence MTs to land uses and property interests, not to pumping geography.
9 Monitoring Network — Infrastructure List Highway 99, Highway 32, City of Chico, Durham EDIT — Add irrigation district infrastructure, Cal Water service area, consultation with infrastructure operators. BMP § 5.2: GSAs to "broadly encompass any infrastructure, land use, and property interest."
10 Measurable Objective 0.0 ft/yr of land subsidence at representative monitoring locations RETAIN — 0.0 ft/yr accepted. BMP § 6.4: "In basins that have not experienced land subsidence, the measurable objective should be set at zero."
11 InSAR + GPS Backbone DWR-provided InSAR data plus one available GPS site as monitoring backbone RETAIN — InSAR + 1 GPS site accepted. RCA 5(b) is disjunctive; § 354.34(c)(6) is disjunctive. DWR has approved InSAR-driven networks in Red Bluff, Los Molinos, Corning, Colusa.
12 Annual InSAR Review InSAR data evaluated annually, with annual rates and cumulative trends considered RETAIN — Annual review framework accepted. Consistent with BMP § 6.1.2's review-cycle framework. Only the MT it is evaluated against changes per Edit 1.
13 Periodic Refinement Number and distribution of monitoring locations periodically reviewed and refined RETAIN — Periodic refinement framework accepted. Consistent with BMP § 6.1's periodic-evaluation framework.
Defensibility. Taken together, this position fully satisfies DWR Recommended Corrective Action 5. Every provision is anchored in the DWR Land Subsidence BMP, in 23 CCR §§ 354.28(c)(5) and 354.34(c)(6), or in a DWR-approved Sacramento Valley comparator GSP. See May 3, 2026 Strawman Redline and Research Memo (v2).

d GDE Technical Memo — Scenario Sensitivity

The March 2026 Vina GSA GDE Technical Study (ESA) analyzed six hydrologic scenarios. The count of polygons classified as "likely GDE" varies by more than an order of magnitude across those scenarios.

Likely GDE polygons by scenario

ESA recommends the highest figure (464) as the regulatory universe. Five of six scenarios yield 100 or fewer polygons. The selection of regulatory universe is a policy choice, not a technical finding.

Headline finding. The Spring-to-Fall ratio at the 90th percentile is ≈12:1; the year-to-year ratio within Spring (90th pctile vs. 2021) is ≈7:1. Season selection drives more variance than year selection.

AGUBC Recommendations

  • Bracketed scenario reporting. All six scenarios presented as policy options; regulatory-universe selection made transparently by the GSA Board.
  • Dual-season screening. A polygon qualifies as "likely GDE" only where groundwater connection is demonstrated in both spring and fall.
  • 2015 baseline with causation requirement. Consistent with Water Code §§ 10721(x)(1) and 10727.2(b)(4); finding must demonstrate change attributable to GSA-controlled pumping, not natural variability.
  • Shallow-aquifer monitoring before binding criteria. Defer binding GDE criteria to the 2032 Periodic Evaluation; let the new shallow well network (approved Dec 11, 2024) produce data first.
  • Applied-water tradeoff analysis. Quantitative analysis of agricultural applied water's net effect on GDEs shall precede any pumping-restriction-based GDE criteria.

e Interconnected Surface Water — Technical Memo Approach

See printed packet for more detail.

f Monitoring Network, MT/MOs, Storage & GDEs

See printed packet for more detail.

g Water Quality, Interbasin Coordination, Project & Management Actions

See printed packet for more detail.

Item 10

General Manager Updates

10a. Legal Implications for Recharge Projects

10b. Well Permit Ordinance Update Process

10c. Interactive Maps

Item 11

Topics for Upcoming Meetings

Item 12

Board Member Announcements, Reports & Requests

Open floor for board members.

Closed Session

Public Employment (Gov't Code § 54957)

Adjournment
